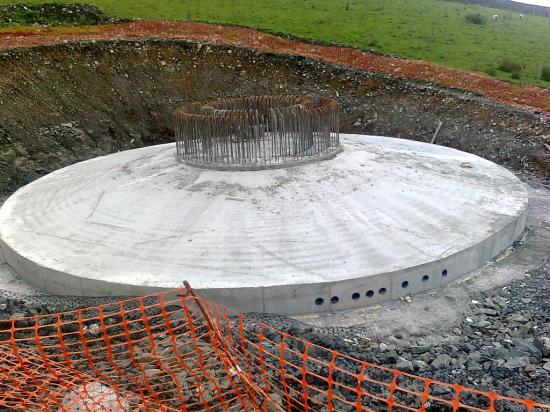

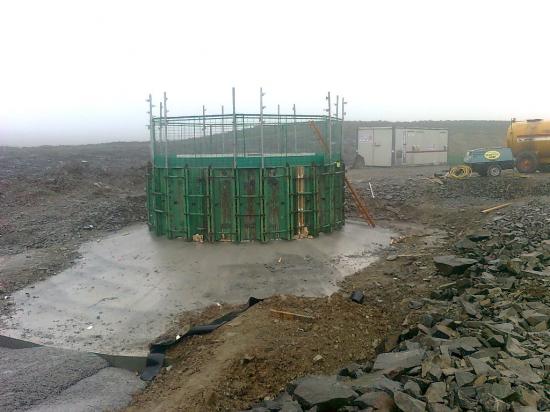

This project commenced for JS structures early July 2012 to the reinforced concrete wind turbine foundations then the bridges and mest mast foundations early August 2012. The project comprises of 230 tonne of reinforcement and 1750 m3 concrete. The programme time to completion is 11 weeks and all is going to programme. |
