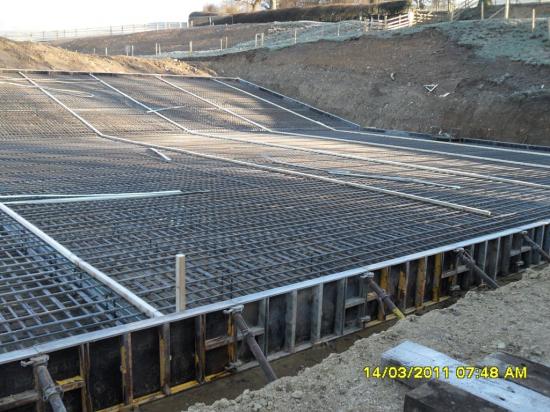

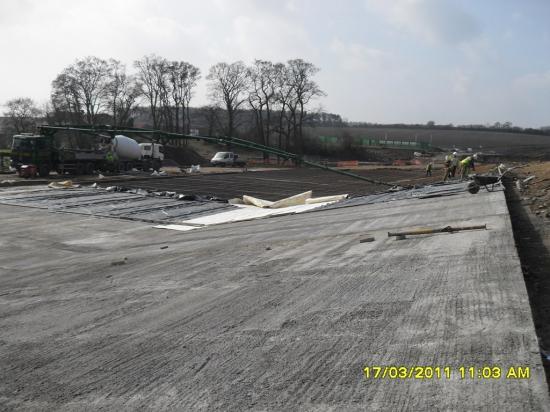

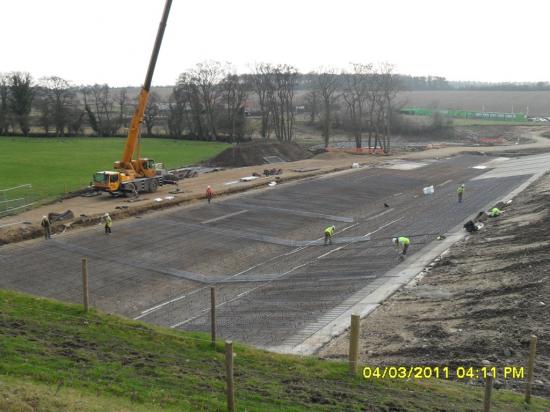

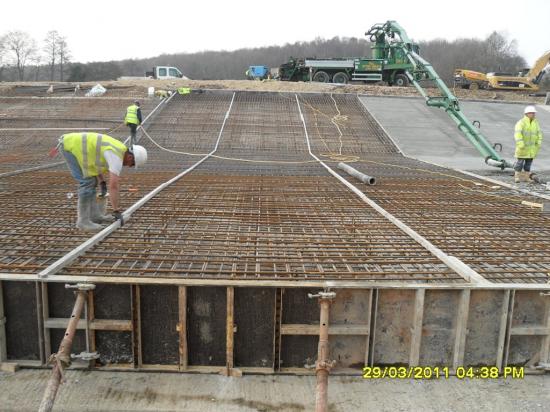

The steelfixing commenced on Monday 28-02-11. 55 tonne of steel reinforcement was fixed to the base slab within the 1st week. 120 tonne of steel reinforcement was completed to the base slab at the end of the 2nd week, and 30% of the base formwork was completed with in the second week. The concrete pours are programmed to commence Monday 14-03-11 and take 15 days to place the concrete. The Concrete Tailbay Structure Was completed on Monday 04-04-11. The reinforced concrete structure took 5 weeks to complete against a 10 week contract programme allowed. | |
